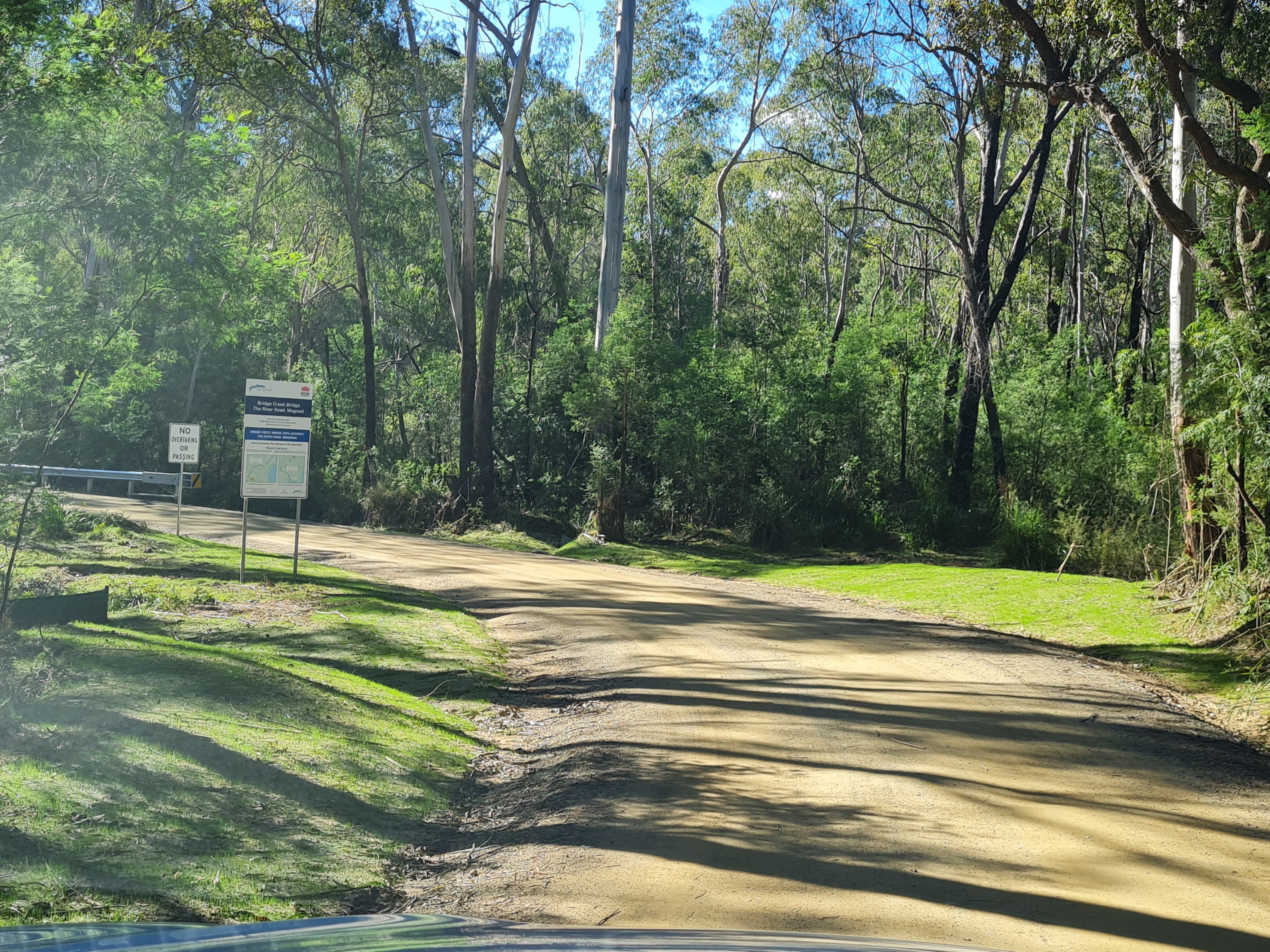

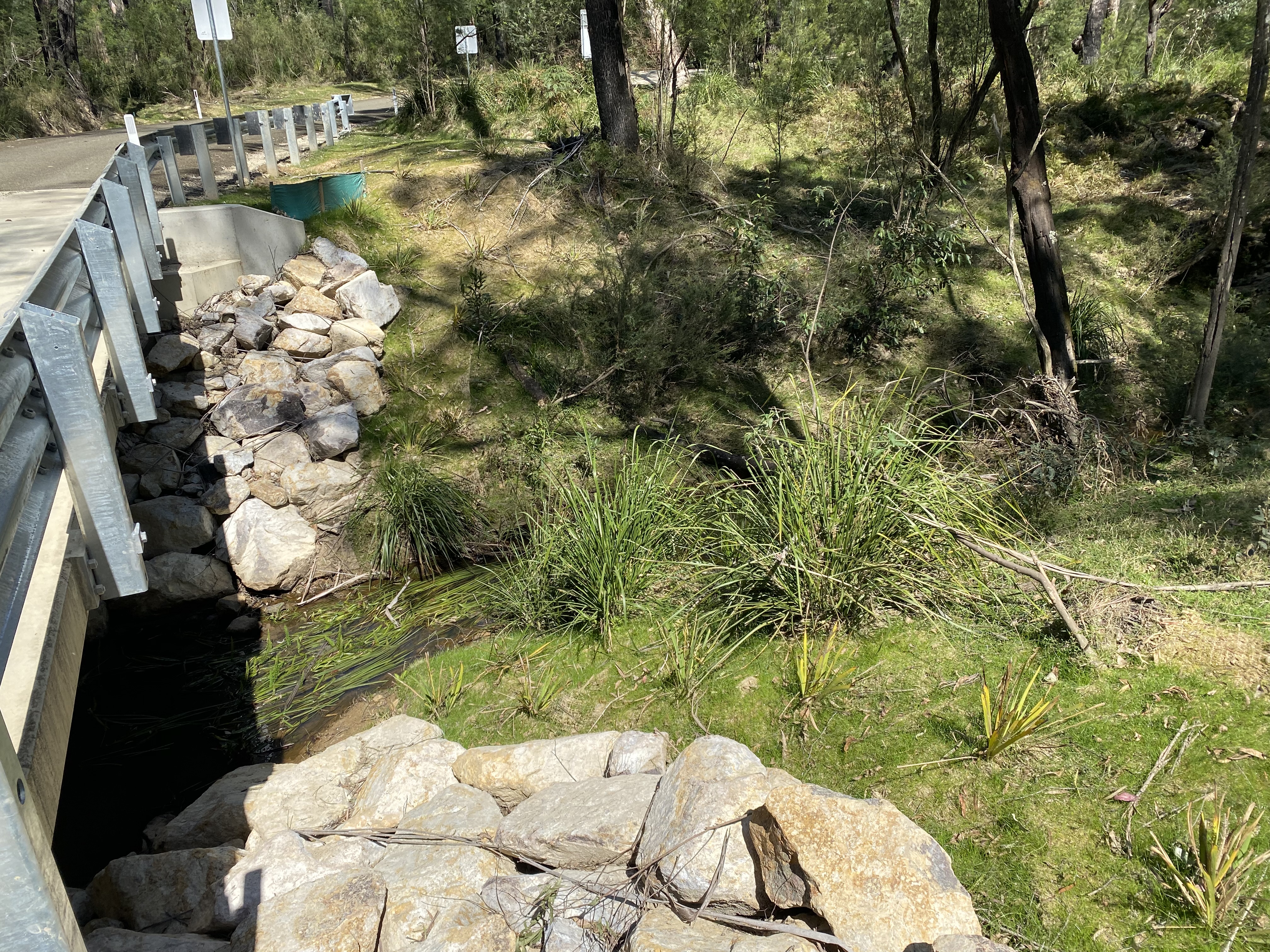

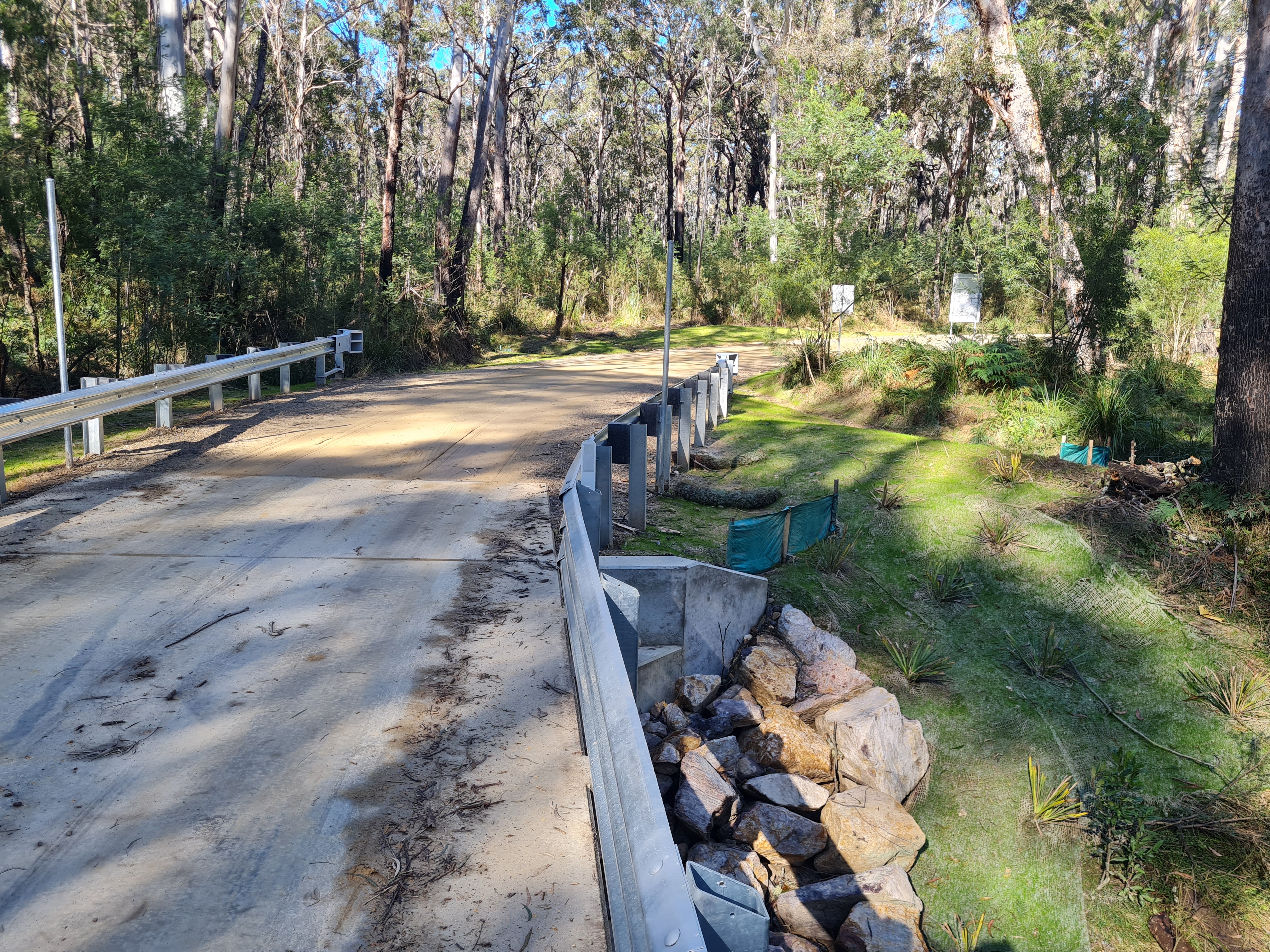

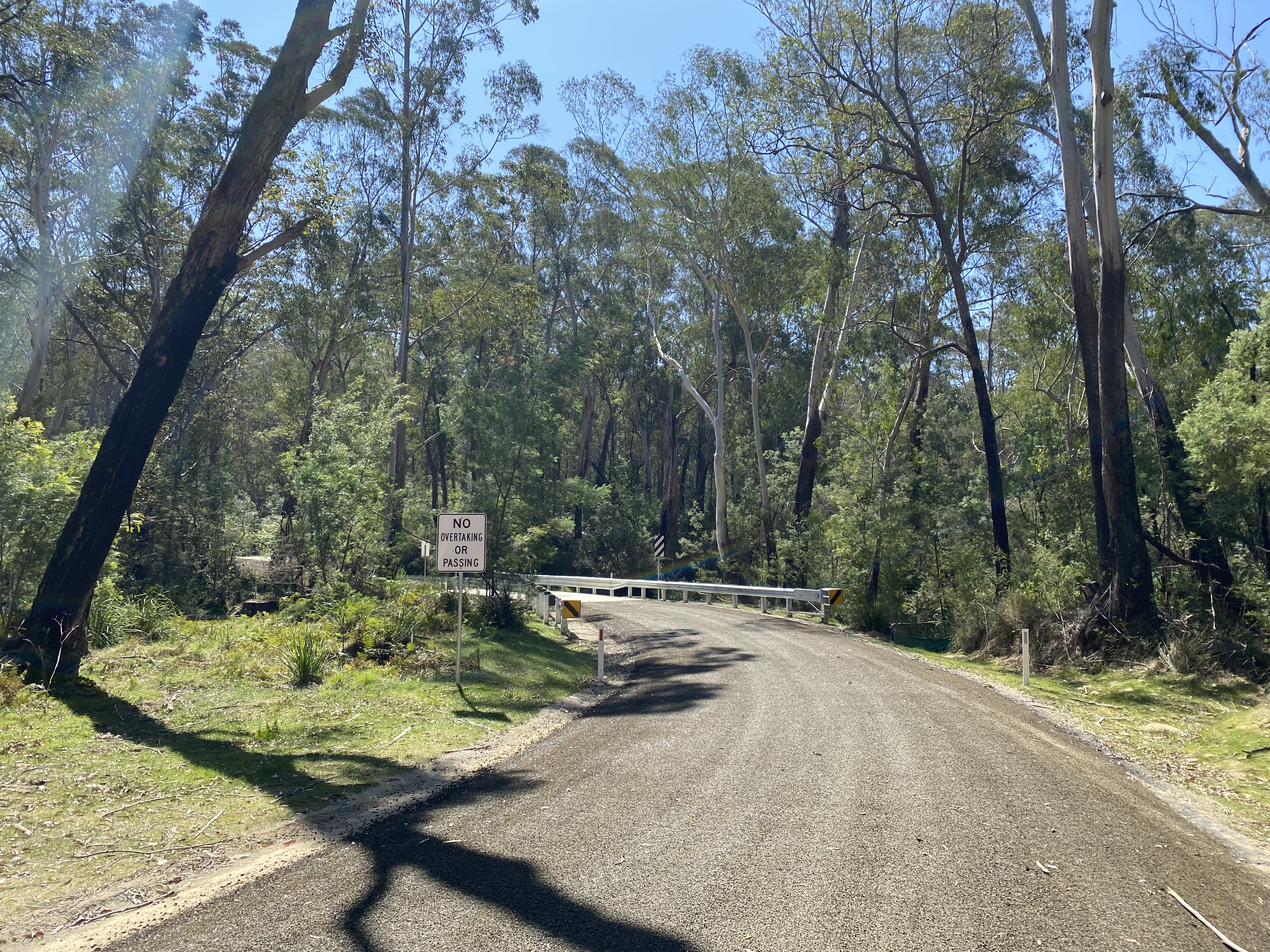

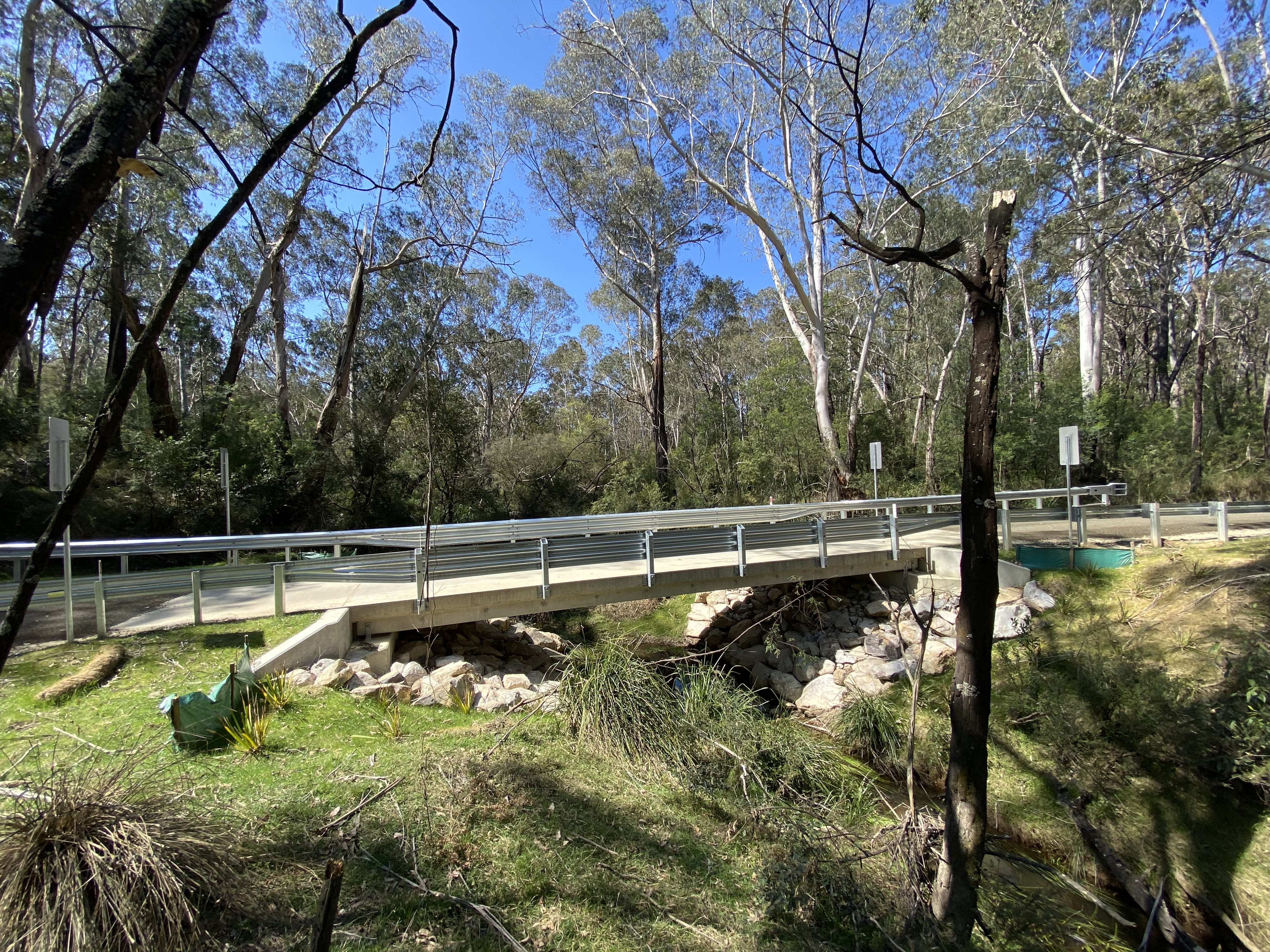

06/08/2024 - The road and bridge were reopened for use on 1st June 2024. Sealing of the road approaches is planned to take place in the last week of August.
06/06/2024 - The road and bridge were reopened for use on 1st June 2024. Sealing of the road approaches will take place in a couple of months at the same time as Boondobah Creek Bridge Replacement.

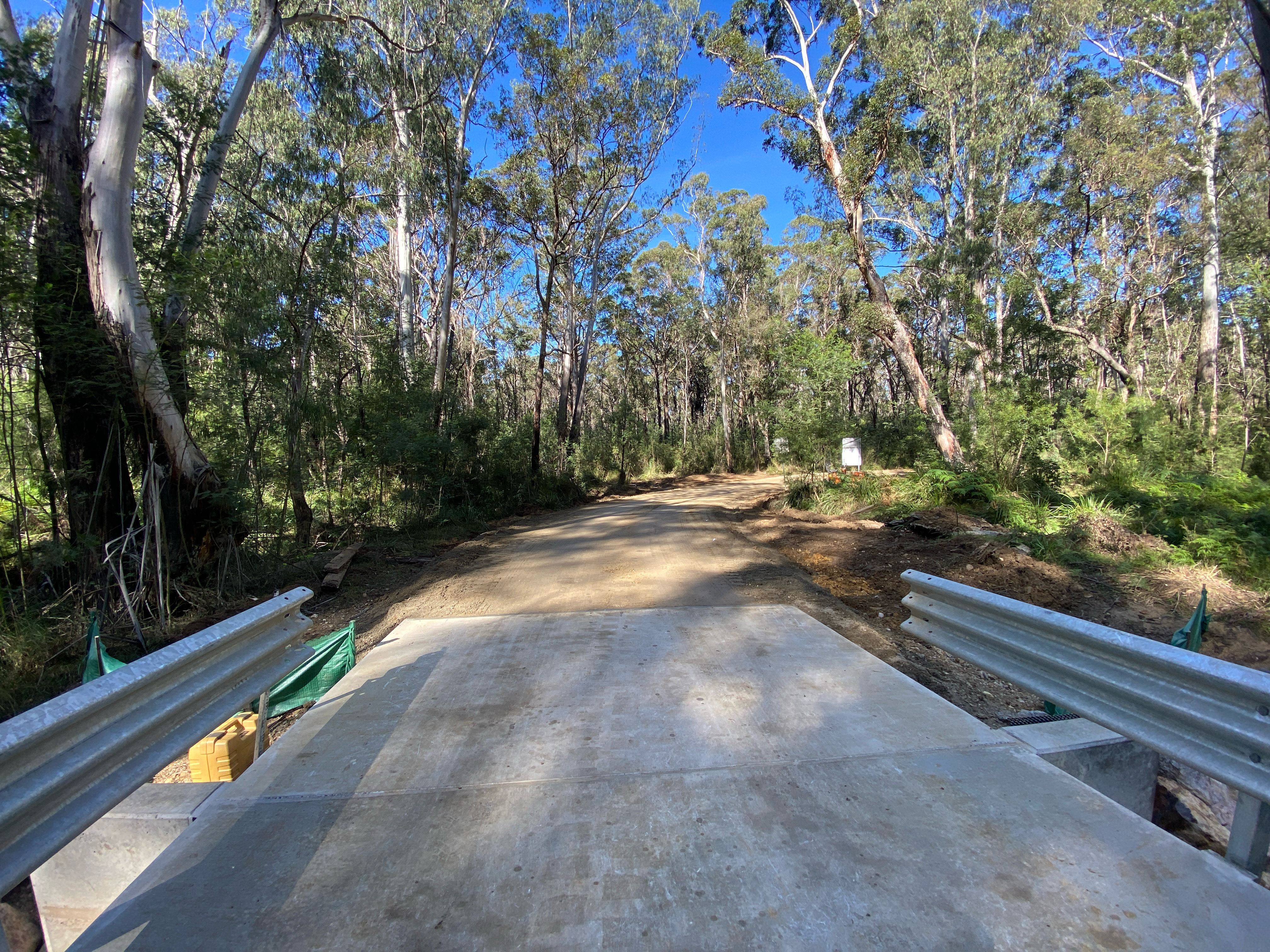

23/05/2024 - Road approaches are nearly complete. Remaining guardrail to be installed next week. Bridge will be open towards the end of next week.
15/05/2024 - Further wet weather delays. Aiming to open the new bridge to traffic on 24 May 2024.
30/04/2024 - Bridge deck is complete. Wet weather throughout the project has delayed construction by two weeks. New expected completion date is 15 May 2024.

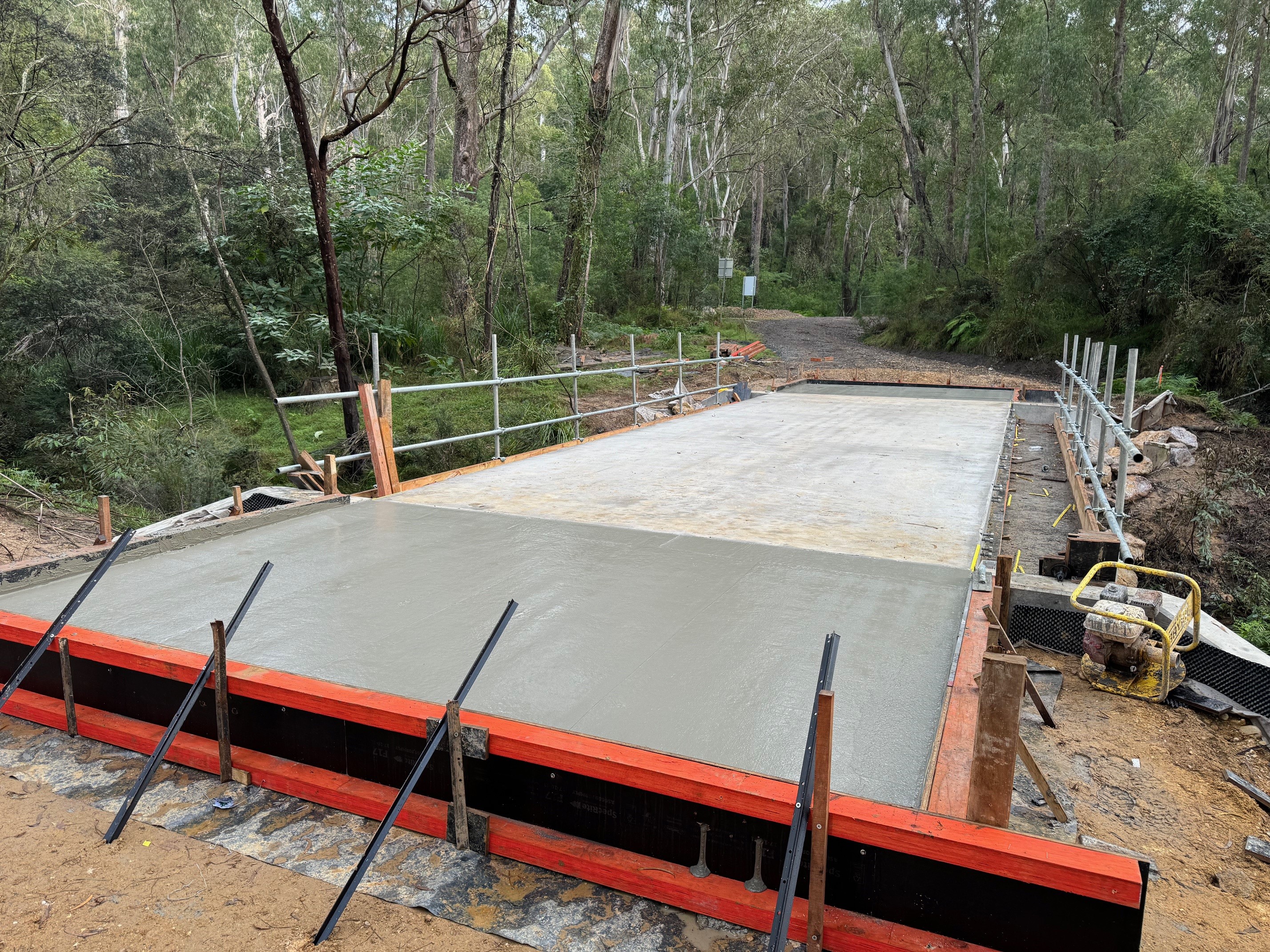

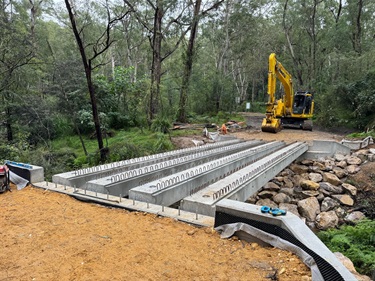

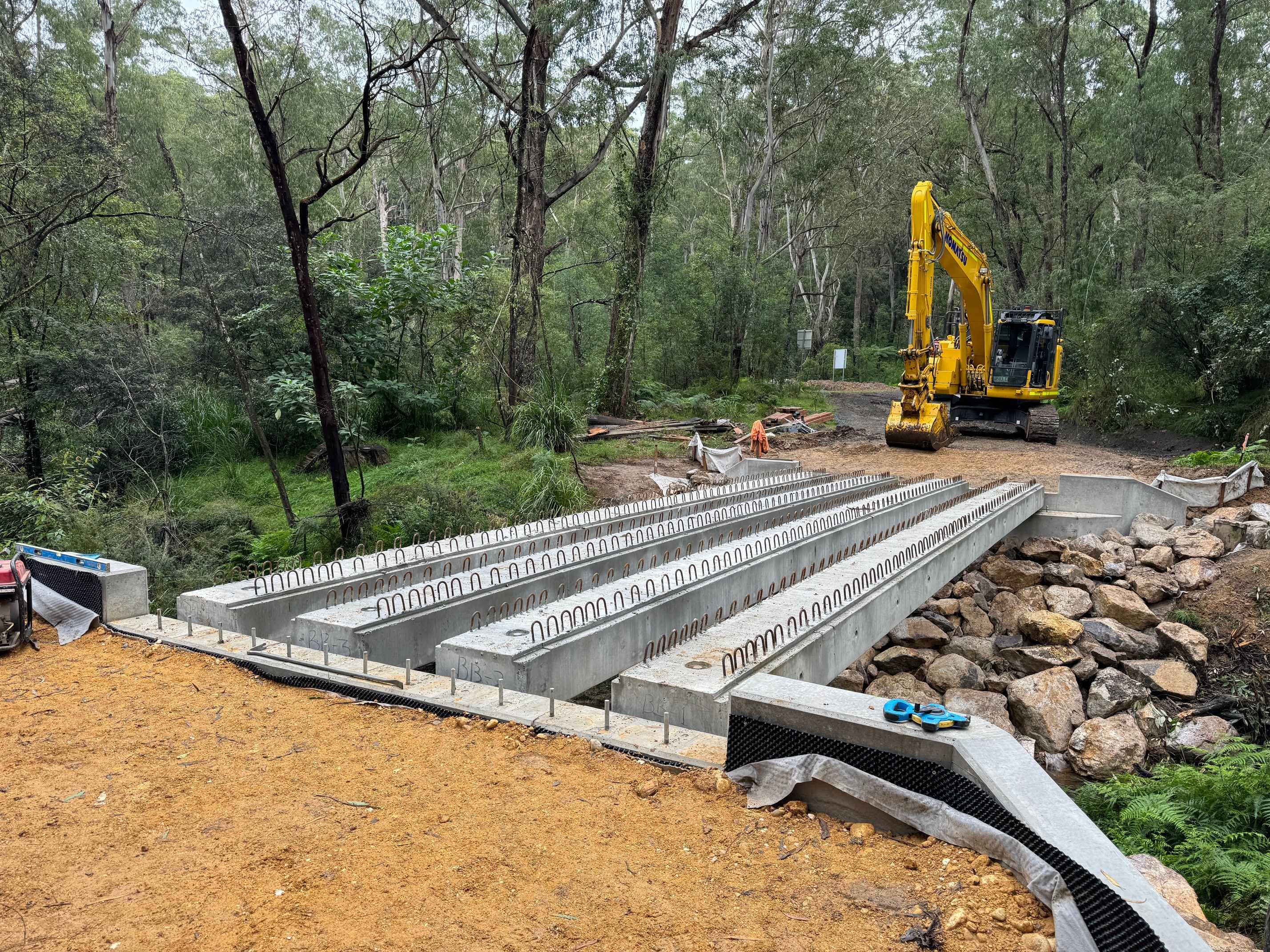

15/04/2024 - Precast planks installed. Bridge deck under construction.

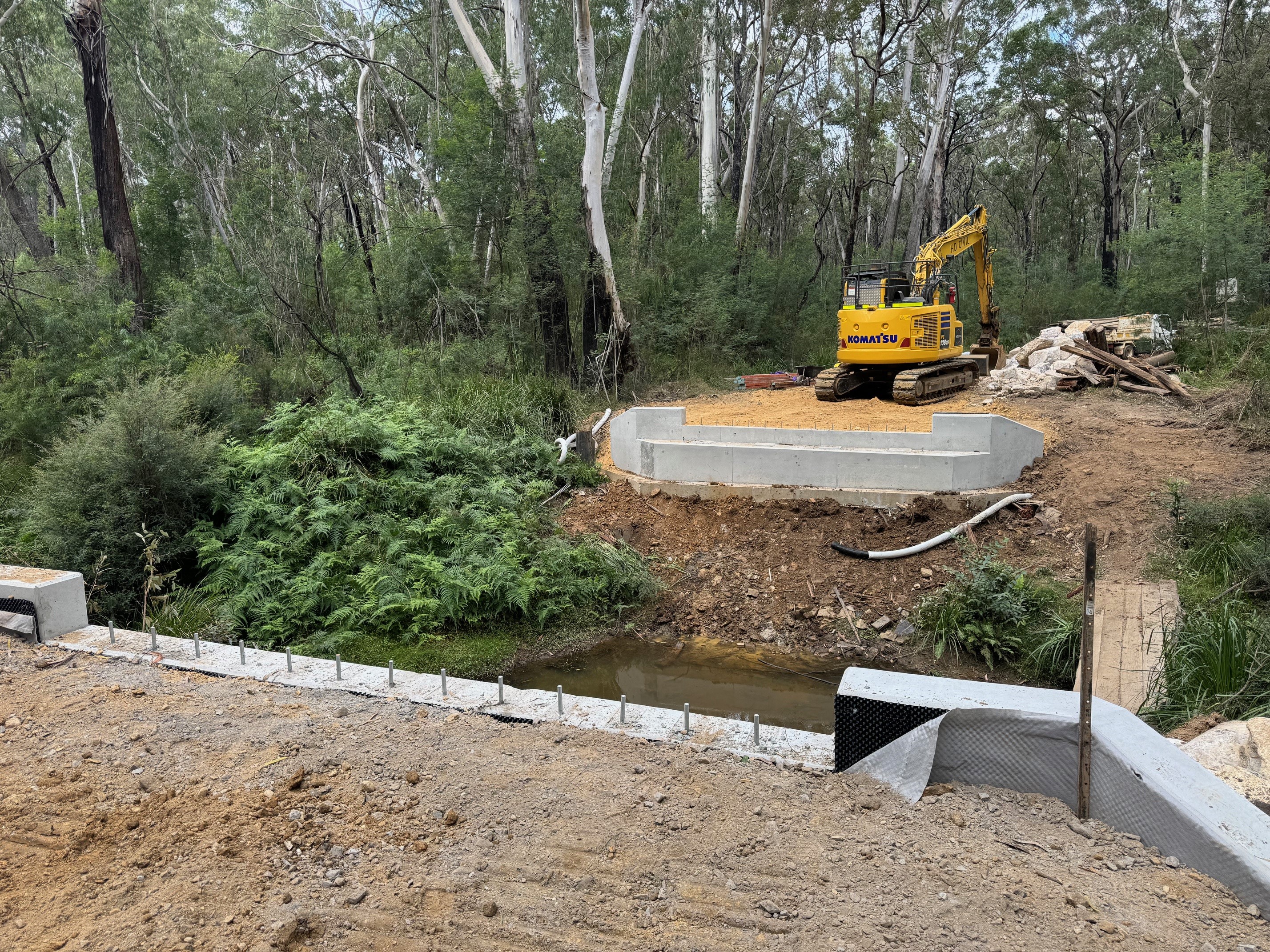

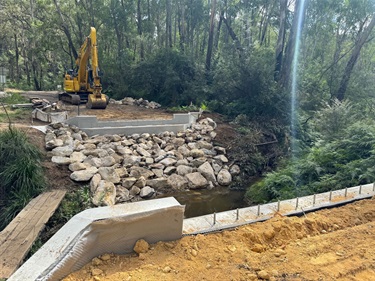

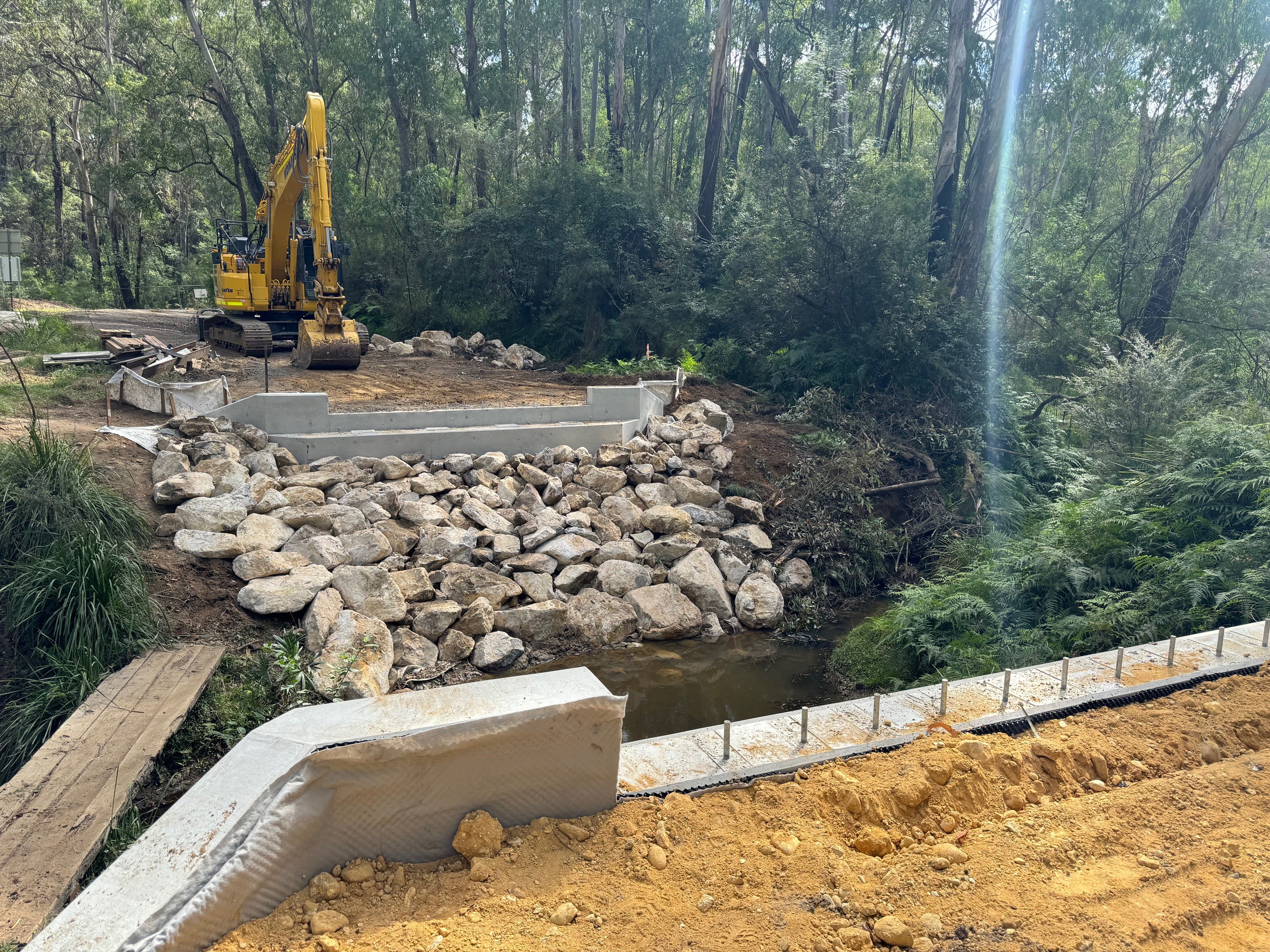

04/04/2024 - Abutments complete. Precast planks to be installed next week.
25/03/2024 - Bridge abutment construction underway.

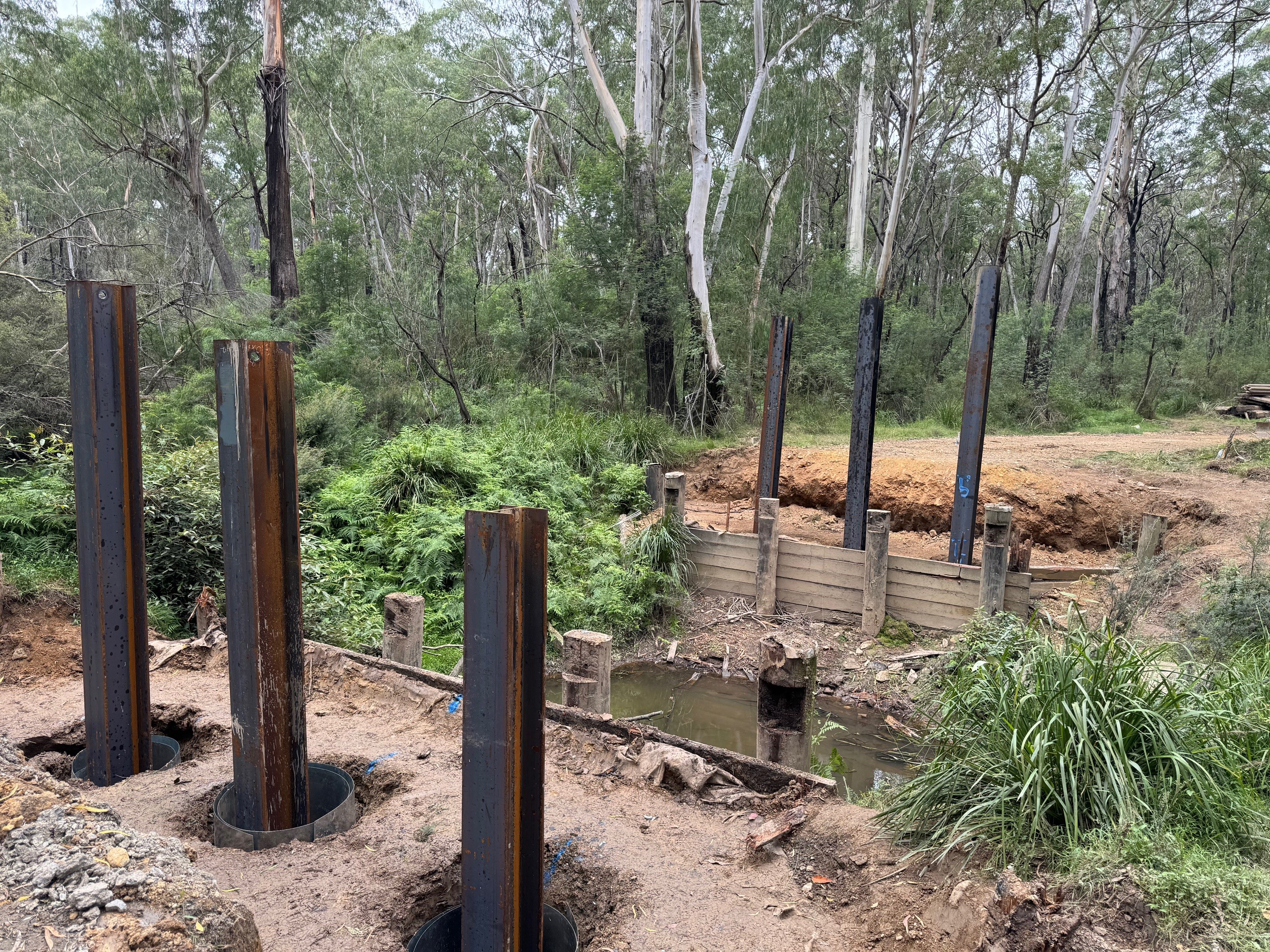

07/03/2024 - Piling works underway.

20/02/2024 - Construction has commenced. Road closed. Demolition of existing bridge is in progress.
25/01/2024 - Construction is set to commence 19 February 2024.
January 2024 Update - The design & construct contract for the works has been awarded. The final design is underway. Expect to start on site mid-Feb 2024.
June 2023 Update - Tender Process commencing in July 2023 for a Design and Construct contract. The awarded contractor to undertake proposed work will be engaged in the Spring of 2023, with design and construction to commence shortly thereafter.
