Murrays Road - Conjola - Murrays Bridge Replacement
Replacement of deteriorated bridge. Work involves the construction of a new, more durable concrete and steel bridge to replace the existing timber bridge.
- Public access
open
Reduced speed
- Where
Murrays Road, Conjola 2539
- Estimated completion date10 July 2025
- Project StatusConstruction
- Last reviewed
20 May 2025
The latest

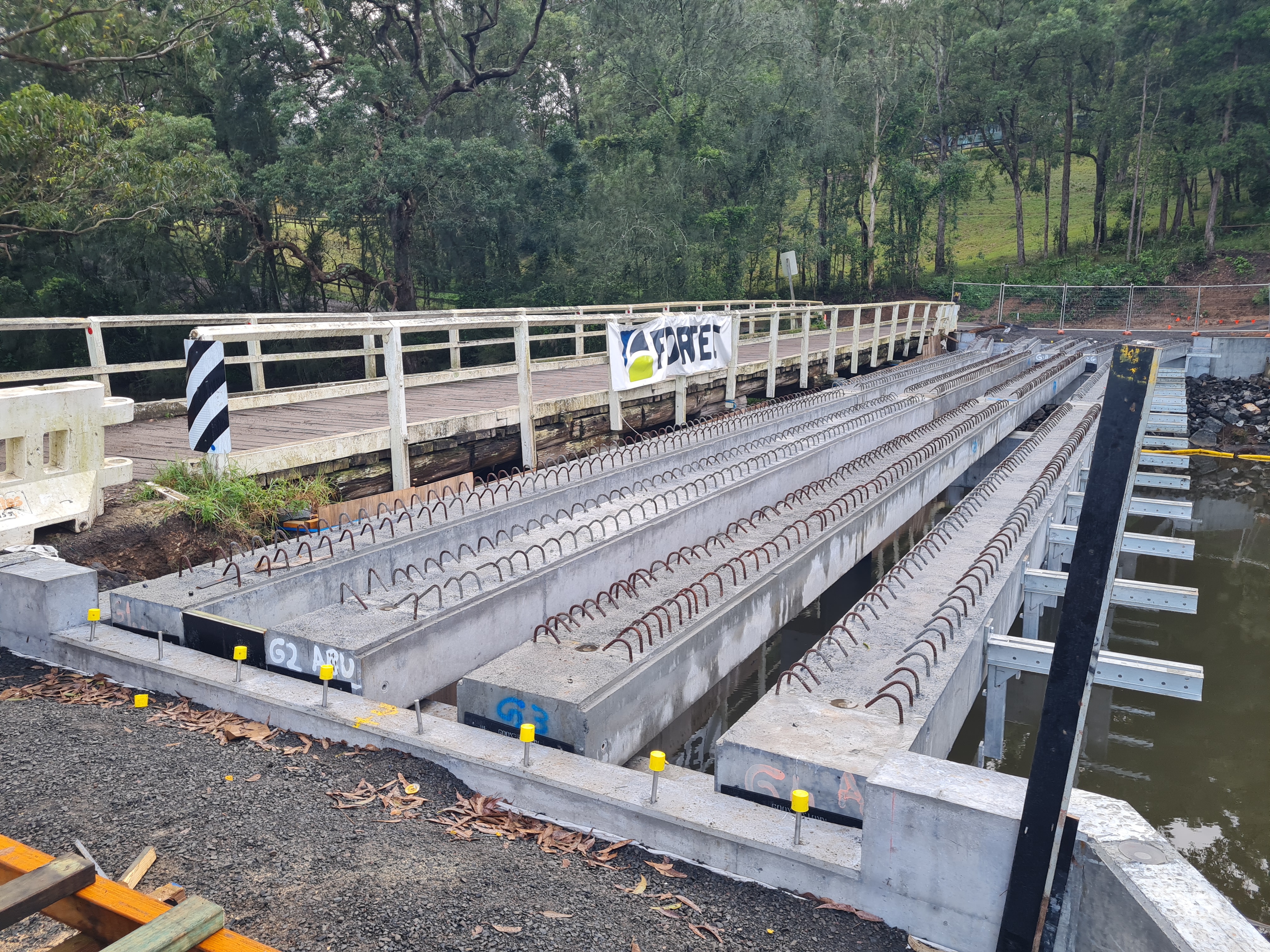

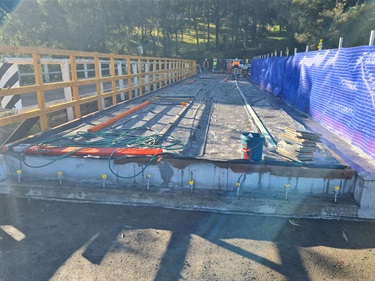

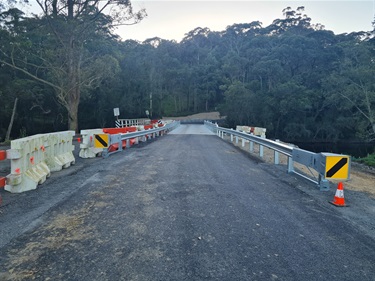

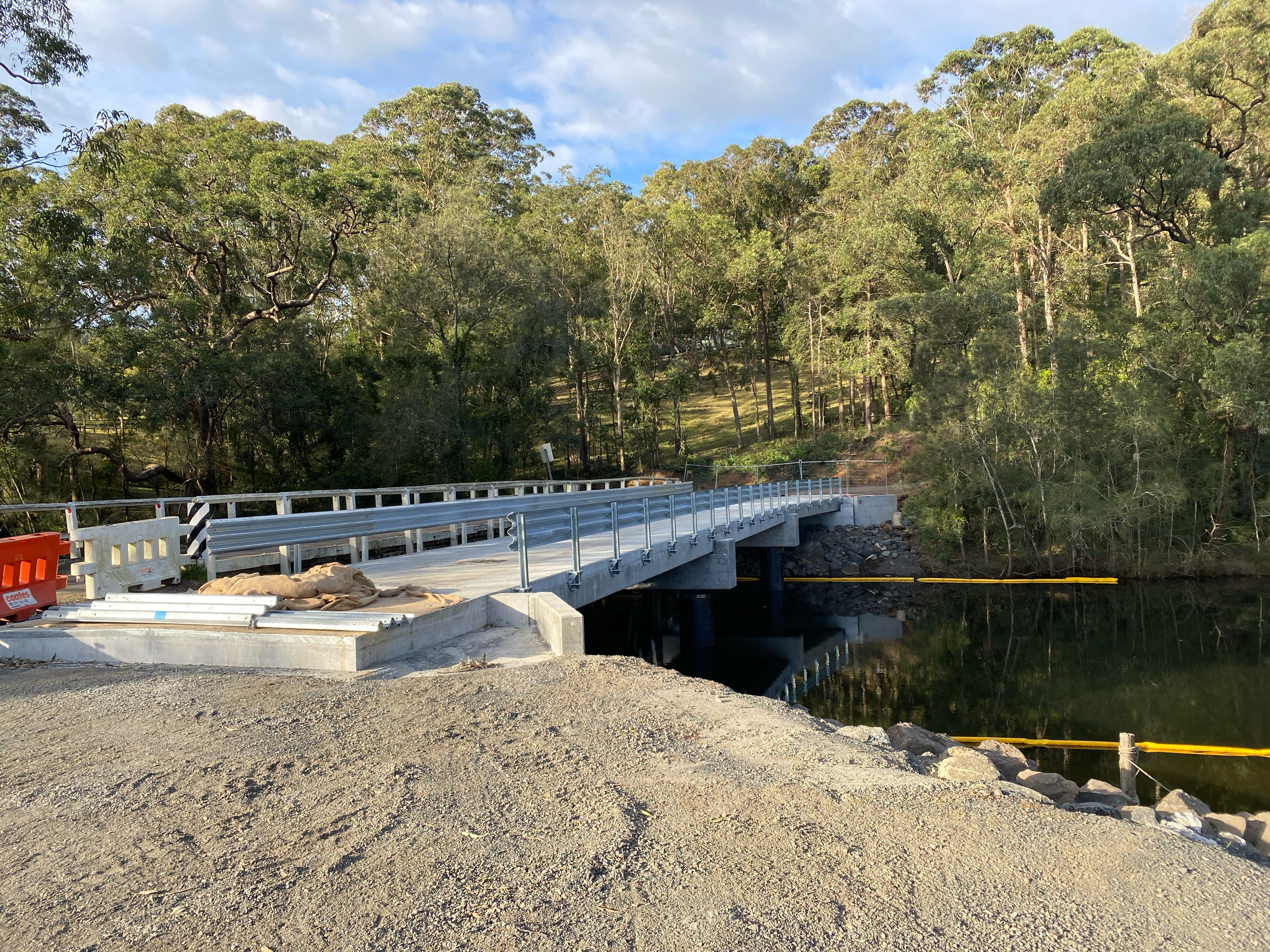

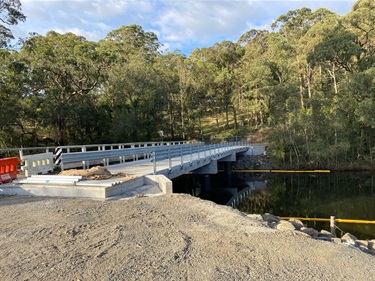

20/05/2025 - Girders are installed. Deck construction in progress.
About the works
Council has successfully been awarded grant funding by TfNSW under the Fixing Country Bridges program to replace this bridge with a new, more durable concrete and steel bridge.
Due to its heritage value the existing bridge will remain in place and the new bridge will be constructed adjacent to it.
The current project schedule is as follows:
- Project Tendering - March to June 2024
- Contract Awarded - July 2024
- Design Phase of the Contract - July to November 2024
- Construction - December 2024 to July 2025
Please subscribe to stay updated on this project.
History

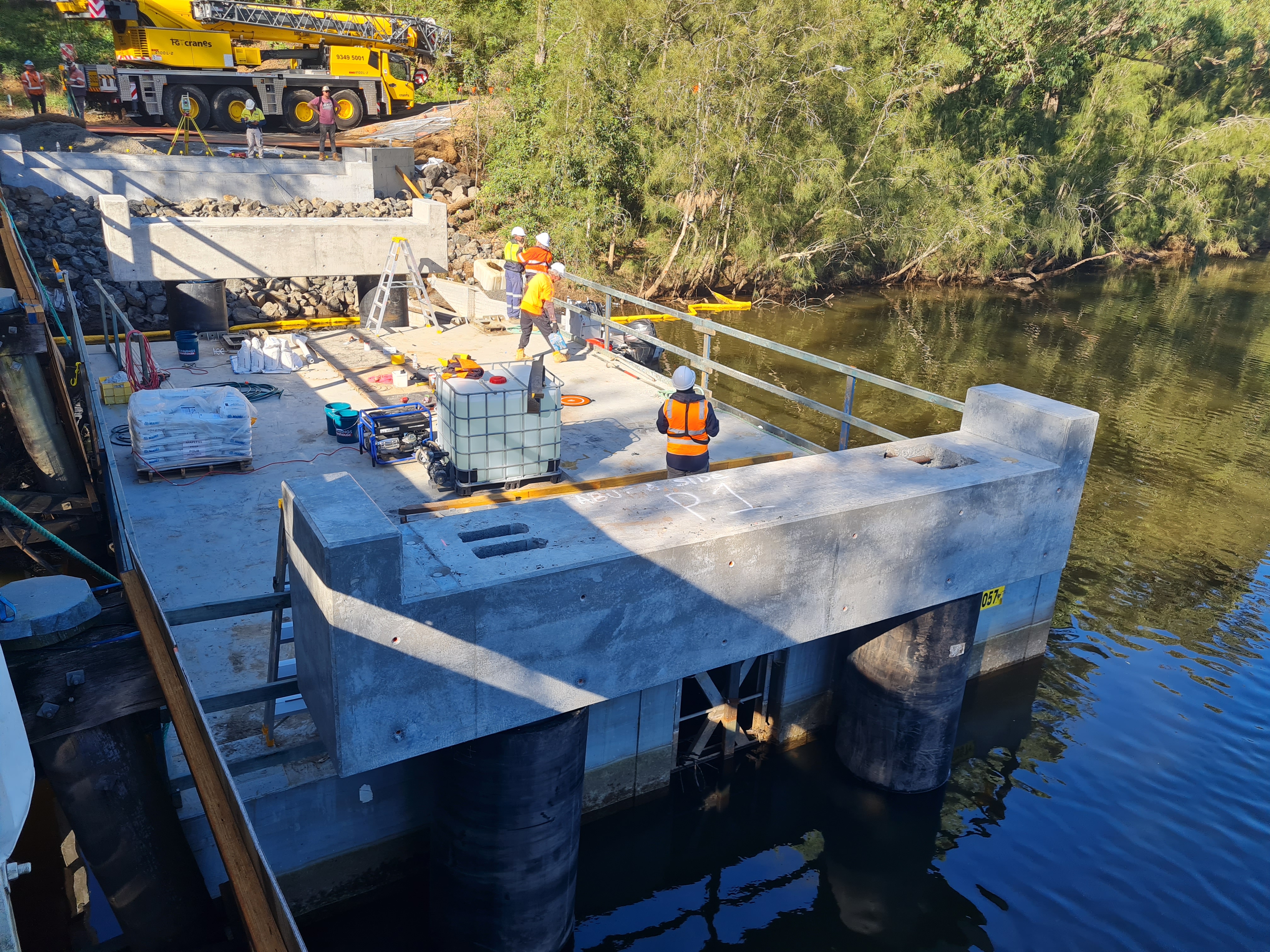

- 12/5/2025 Update - Headstocks are installed. Girders to be installed on Wednesday 14/05 & Friday 16/05. The road on the southeast side of the bridge will be closed on Friday 16/05 while the crane is setup on the eastern side of the bridge. Please use Bendalong Mountain Road for resident access on 16/05/2025.
- 06/5/2025 Update - Headstocks to be installed on Thursday 08/05 & Friday 09/05. The road on the southeast side of the bridge will be closed on Thursday 08/05 while the crane is setup on the eastern side of the bridge. Please use Bendalong Mountain Road for resident access on 08/05/2025.

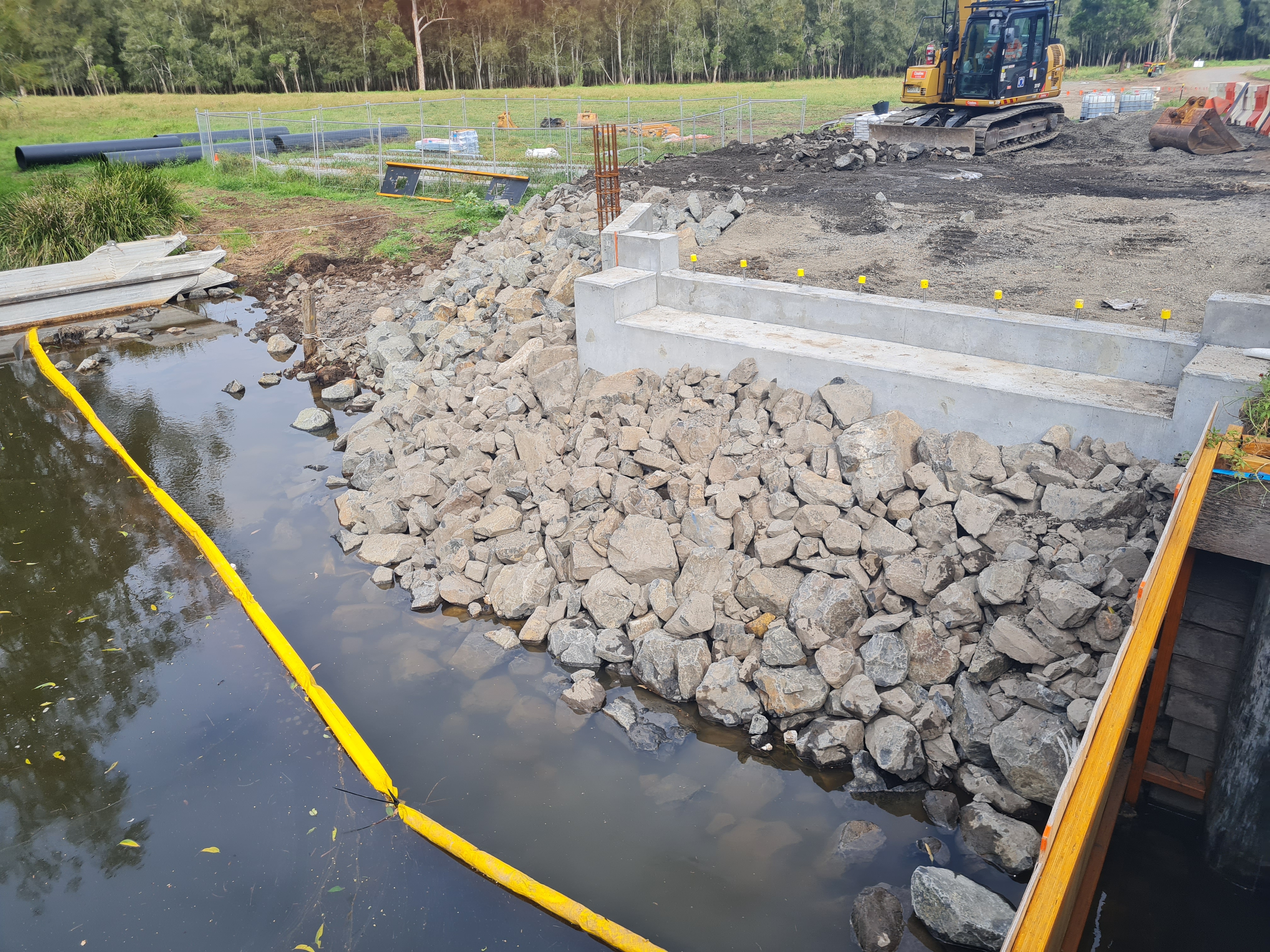

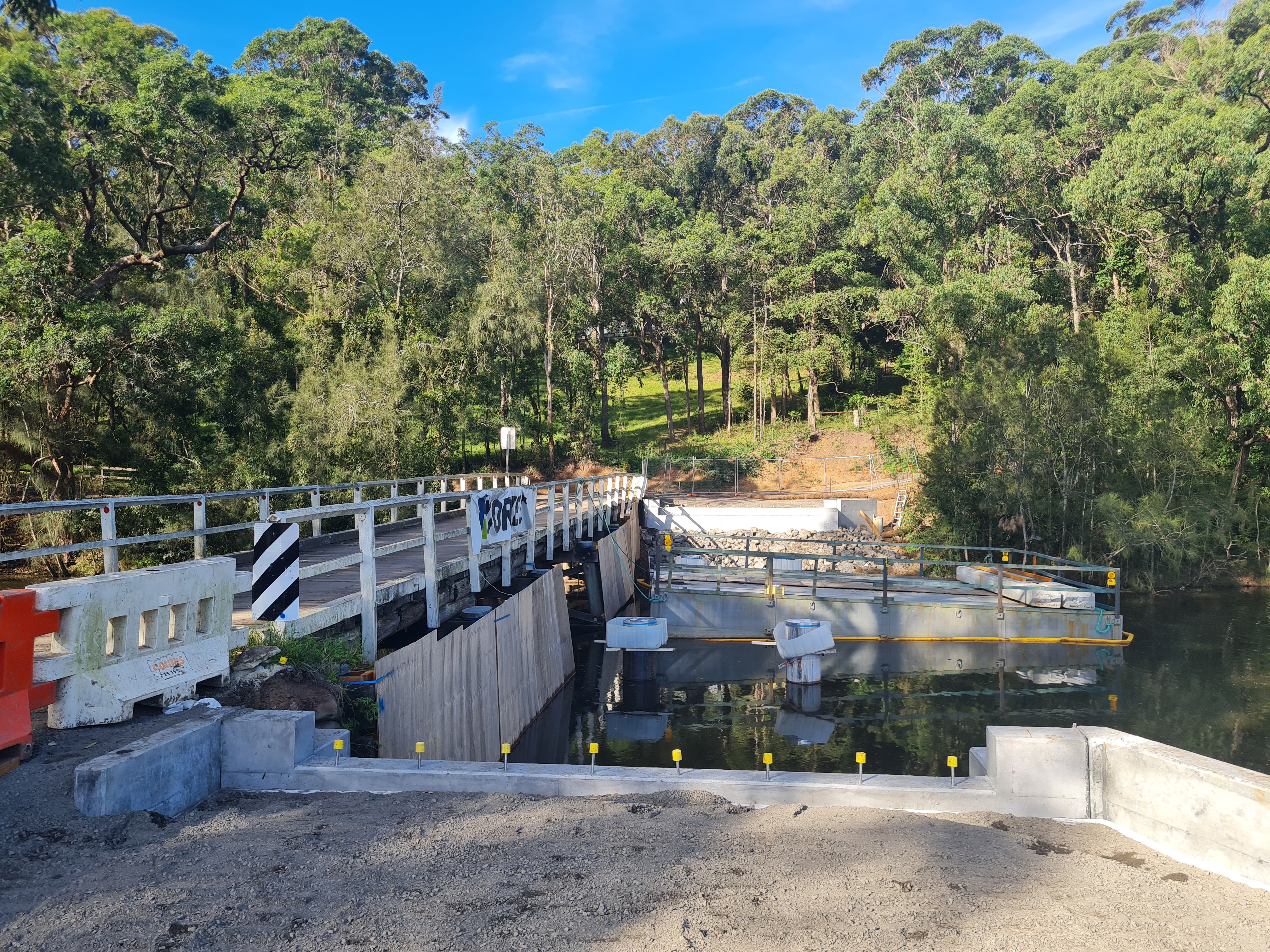

- 16/04/2025 - Abutment construction is complete. Headstocks and girders to be installed in the coming weeks.

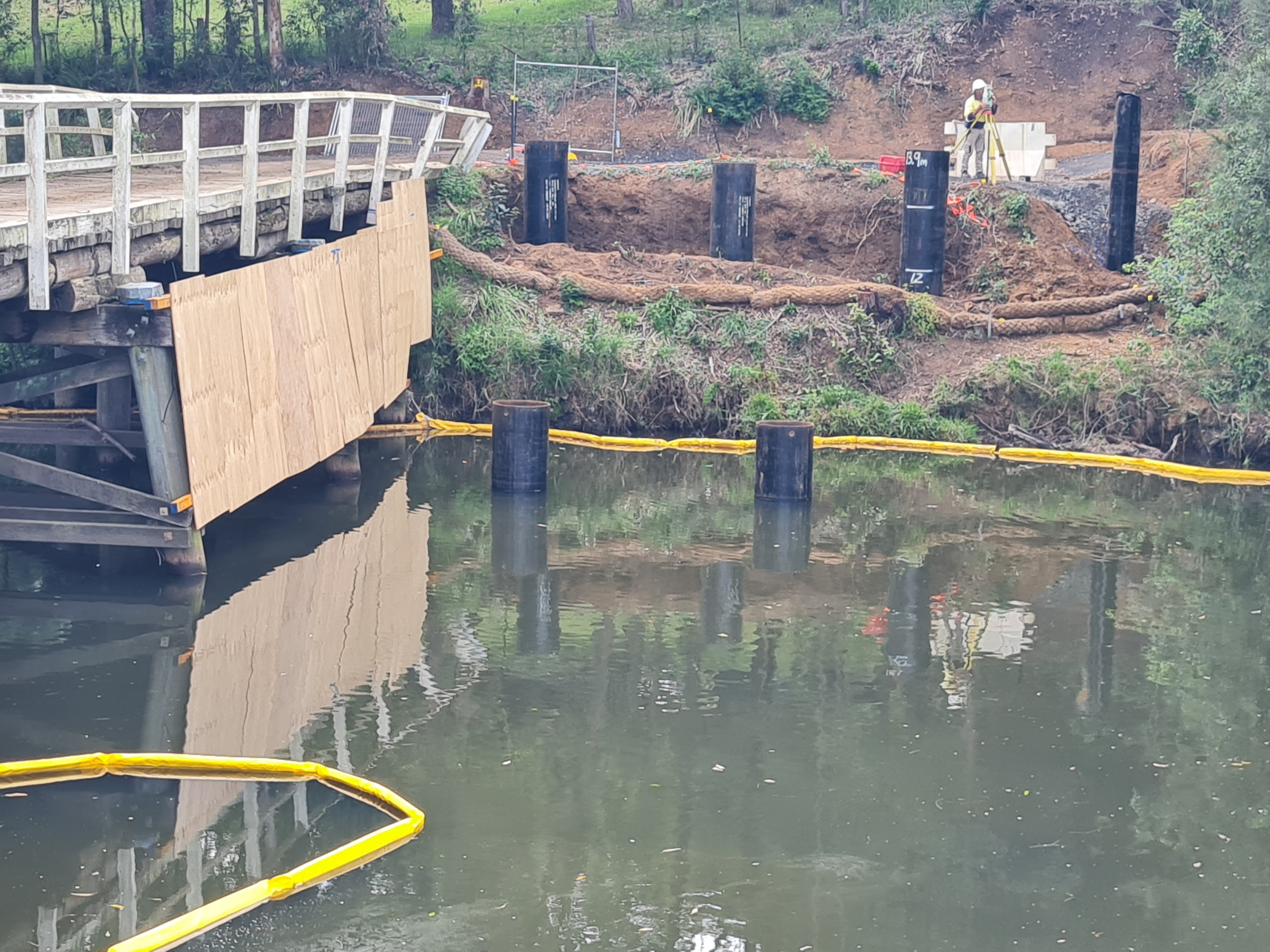

- 27/02/2025 - Piling works are nearing completion.

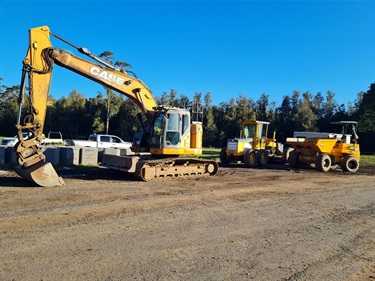

- 30/01/2025 Update - Rehabilitation of Bendalong Mountain Road is complete. Piling works will commence on Monday 03 February 2025. Bendalong Mountain Road will provide an alternative access for residents on the southeastern side of Murrays Bridge during the piling works. Refer to the contractor's resident notification in the related documents section for further information.
- January 2025 Update - The casting yard has been moved to an off-site location. Rehabilitation of Bendalong Mountain Road is in progress. Bendalong Mountain Road will provide an alternative access for residents on the southeastern side of Murrays Bridge during the piling works. Refer to the contractor's resident notification in the related documents section for further information.
- December 2024 Update - A site shutdown is in place until 13 January 2025. Onsite fabrication of precast concrete items and remediation of the access to Bendalong Road will recommence on 13 January 2025. Bridge construction, including piling, is expected to commence on 28 January 2025.
- November 2024 Update - Site establishment and onsite fabrication of precast concrete items to commence from 20 November 2024. Bridge construction, including piling, is expected to commence on 28 January 2025.
- October 2024 Update - Site establishment and onsite fabrication of precast concrete items is expected to take place in December 2024. Bridge construction, including piling, is expected to commence on 20 January 2025.
- September 2024 Update - Design finalisation in progress.
- August 2024 Update - The Design & Construction Contract has been awarded. Additional Geotechnical Investigation planned for Wednesday 14 August to Friday 16 August.
- July 2024 Update - Tenders have been evaluated and the recommendation will be put forward at the 22 July 2024 Council Ordinary Meeting.
- June 2024 Update - Tenders are being evaluated.
- April 2024 Update - Design and Construct tender submissions due 24 May 2024.
- January 2024 Update - Project to be tendered as a design & construct contract in February 2024.
