Announcement
Landslip repair drop-in sessions:
THURSDAY 30 March 4 – 5 pm
THURSDAY 13 April 4 – 5 pm
Drop by the Kangaroo Valley Community Hall (177 Moss Vale Rd) where contractor Symal and Council staff will answer your questions about upcoming road works.
- Project StatusIn progress
- Last reviewed
23 March 2023
The latest
3/3/2023 - The construction program outlining the planned start and finish dates for the 38 Major Landslip repair work has been released.
See Major Landslip Repairs below for more information.
About the project
Information on your local road can be found on Council’s road works page.
The July 2022 east coast low natural disaster event brought with it torrential rain, damaging winds and floods that resulted in widespread landslips, road damage and isolation for some in our community.
The Shoalhaven community showed incredible resilience again following the March 2022 natural disaster event that brought more heavy and sustained rainfall that caused further widespread damage to our public infrastructure and impacted many in our community.
The September 2022 severe weather and floods was also declared natural disaster but mainly caused widespread damage to communities in western NSW. This same weather event also impacted the Shoalhaven LGA although the damage to our infrastructure and the impacts to our community this time was much milder.
On this page
Background
For the months of January to July 2022, rainfall in Barrengarry alone reached a total of 2,059mm (see related documents) compared to an average rainfall for the same period of 854mm and was more than double the rainfall what residents would normally experience. This follows two summers of La Niña weather patterns with a third La Niña expected over the 2022/23 summer expecting to bring more heavy rainfall and flooding.
During this time 3 severe weather events were declared natural disasters by the NSW Government:
- AGRN1012 – NSW severe weather and flooding from 22 February 2022 onwards
- AGRN1025 – NSW severe weather and flooding from 27 June 2022 onwards
The impacts on public infrastructure were significant, including:
- 1200 records of damage and emergency works across the Shoalhaven
- an estimated $75 million in damaged roads
- an estimated $4 million in damage to flood levees
- 98 landslips (38 classified as major) affecting 23 roads
- 13 sinkholes
The estimated cost to repair the damage is nearly 4 times the value of Council's normal roads and transport annual capital work construction program budget. To respond to this challenge, Council set up a dedicated natural disaster reconstruction team to focus on the repair work.
The above data is as of July 2022. For updated data see Ordinary Council Meeting reports in Related Documents.
The severe weather and floods in September 2022 were also declared natural disaster.
- AGRN1034 – NSW severe weather and flooding from 14 September 2022 onwards
Natural Disaster Funding Arrangements
As both severe weather events have been recognised as natural disasters, Council is eligible for federal funding to restore essential infrastructure under strict conditions outlined in
Under these funding arrangements, Council is seeking funding under Category B measures for ‘restoration of essential public assets’. There are three distinct stages of restoration works:
Stages of Restoration Works
Stage 1 (emergency work) - Completed
Removal of debris to allow restricted traffic movement.
Load limits (refer below) and traffic management have been imposed on some roads around the region to improve driver safety and prevent further road damage.
Stage 2 (immediate reconstruction work) - Completed
In certain locations, significant repair work has been completed to improve public safety and restore property access for residents.
See related documents for a list of the immediate reconstruction works completed to date.
Stage 3 (essential public asset reconstruction work) - In Progress
Stage 3 involves the investigation, design and construction of the initial 38 high priority landslip repairs impacting roads is a large undertaking and planning for this work is well underway.
Planning for the lower priority works, including initial investigation, recommendations and concept designs, will commence early November 2022 and will follow a similar process to the higher priority works.
Major Landslip Repairs (Stage 3)
3/3/2023 - The latest construction program proposed by the contractor Symal for the 38 the Major Landslip repair work has been released and is available in the related documents on this page. See "Major Landslip Package Program March 2023".
A summary of this construction program is also shown below by clicking on the heading "Major Landslip Package Planned Program of Work”
21/2/2023 - As previously reported, Council resolved on the 15th February 2023 to proceed with the appointment of infrastructure and construction group Symal to repair the 38 major landslips affecting 15 of Shoalhaven Council’s roads. Council has provided Symal a schedule of works which prioritises the most urgent landslips with the first round of works expected to begin in late March 2023.
This week Council project management team will be meeting with the contractor to confirm planned dates when individual landslip repairs will commence. This project master page and the 15 individual roadworks pages will be updated to provide the planned commencement dates for the 38 landslip repairs as soon as these dates are confirmed. You can view the list of major landslips and the assigned construction priorities by clicking on the heading “Major landslip package priorities” below.
14/02/2023 - Contract awarded - Council has resolved to proceed with the appointment of infrastructure and construction group Symal to repair the 38 major landslips. Council has provided Symal a schedule of works which prioritises the most urgent landslips with the first round of works to begin in late March 2023. To view the list of major landslips and the assigned construction priorities, refer to the Major landslip package priorities below.
22/12/2022 - Four tenders for the repair of 38 landslips were received. A comprehensive evaluation process has been completed and a recommendation has been forwarded to Public Work Advisory (PWA) for endorsement. It is anticipated that PWA will evaluate the tender acceptance report and respond to Council mid-January.
Previous Progress Updates
15/12/2022 - Tender Process for the Landslip packages is progressing well.
The current status of the Landslip Tender is as follows
- Council has received four bids in the tender box.
- Non-price evaluation is complete with promising proposals from experienced contractors.
- Price evaluation is nearing completion with final checks and balances being considered for each submission.
- Project references and financial checks on each of the bidders is currently underway.
- After the above checks, direct discussions with preferred tenderers will be undertaken.
- Based upon evaluation to date we are confident that the tender process will result in an award of the works.
- From review of the submissions both options A and B as per Councils strategy are real possibilities under consideration.
- Prior to the Christmas break the evaluation team is confident that the process will be complete with reports sent for endorsement.

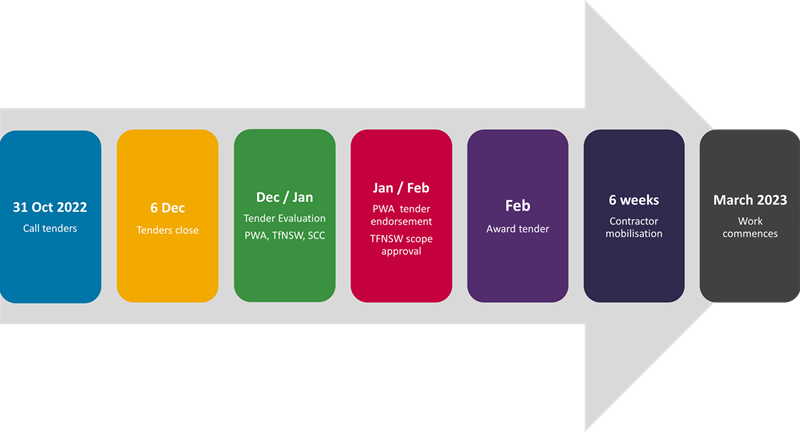

31/10/2022 - The investigation, design and construction of the initial 38 high priority major landslip repairs impacting roads is a large undertaking and planning for this major program of work is well underway.
Geo-technical consultants, SLR Consulting P/L, have been engaged to undertake the detailed investigation and design of the landslip repair work of the 38 high priority sites. The investigation and drilling work is now complete as well as the environmental due diligence assessment and preliminary cost estimates. Design work has now reached 85%.
With assistance from the NSW Public Works Advisory, tender documents for the 38 high priority works were completed and issued for public tender on 31 October 2022 and closed on 6 December 2022.
eTendering - Current Tender Detail View - RFT-10053781 (nsw.gov.au)
The extensive tender evaluation process is likely to take several weeks depending on the quantity and quality of the tenders submitted. Prior to Council accepting any tender, Council has an obligation to seek final endorsement from the NSW Public Works Advisory regarding the preferred tender, as well as endorsement from TfNSW who approves the final scope of work, the allocation of Natural Disaster funds and verifies compliance with the NSW Disaster Assistance Arrangements.
Allowing for the Christmas shutdown period, a tender for the 38 major land slip repair work is likely to be accepted in late January 2023 which will allow Council to enter into a construction contract.
Depending on the time it takes for the contractor to mobilise equipment, staff and to procure materials it is now most likely repair will commence in March 2023.
Major Landslip Package Planned Program of Work
Location
|
District
|
Rural Address (approx)
|
Road
Chainage
(kms)
|
Planned Start
|
Planned Finish
|
Bunkers Hill Rd
|
Northern
|
159
|
1.580-1.600
|
10-May-23
|
29-Jun-23
|
Bunkers Hill Rd
|
Northern
|
175
|
1.720-1.780
|
16-May-23
|
29-Jun-23
|
Bunkers Hill Rd
|
Northern
|
183
|
1.800-1.860
|
23-May-23
|
29-Jun-23
|
Bunkers Hill Rd
|
Northern
|
212
|
2.080-2.160
|
27-Jun-23
|
18-Oct-23
|
Bunkers Hill Rd
|
Northern
|
394
|
3.900-3.980
|
27-Jul-23
|
17-Oct-23
|
Upper Kangaroo River Rd
|
Northern
|
676
|
6.720-6.800
|
18-Apr-23
|
31-Aug-23
|
Upper Kangaroo River Rd
|
Northern
|
691
|
6.880-6.940
|
18-Jul-23
|
31-Aug-23
|
Upper Kangaroo River Rd
|
Northern
|
755
|
7.520-7.580
|
04-Aug-23
|
31-Aug-23
|
Upper Kangaroo River Rd
|
Northern
|
1291
|
12.900-12.920
|
08-Aug-23
|
31-Aug-23
|
Burrier Rd
|
Central
|
730
|
0.540-0.920
|
10-May-23
|
07-Aug-23
|
Burrier Rd
|
Central
|
377
|
3.640-3.900
|
14-Jun-23
|
07-Aug-23
|
Burrier Rd
|
Central
|
333
|
3.320-3.340
|
18-Jul-23
|
07-Aug-23
|
Burrier Rd
|
Central
|
610
|
5.780-6.420
|
16-May-23
|
08-Aug-23
|
Woodhill Mountain Rd
|
Northern
|
552
|
5.420-5.620
|
11-May-23
|
16-Jun-23
|
Woodhill Mountain Rd
|
Northern
|
570
|
5.640-5.760
|
17-May-23
|
30-Jun-23
|
Foremans Rd
|
Northern
|
43
|
0.370-0.490
|
24-May-23
|
08-Aug-23
|
Foremans Rd
|
Northern
|
32
|
0.280-0.360
|
03-Jul-23
|
08-Aug-23
|
Kangaroo Valley Rd
|
Northern
|
1260
|
12.6
|
07-Aug-23
|
11-Aug-23
|
Kangaroo Valley Rd
|
Northern
|
1167
|
11.660-11.680
|
11-Aug-23
|
31-Aug-23
|
Mount Scanzi Rd
|
Northern
|
823
|
8.220 - 8.240
|
28-Jun-23
|
21-Jul-23
|
Mount Scanzi Rd
|
Northern
|
794
|
7.900-7.980
|
11-Jul-23
|
06-Sep-23
|
Mount Scanzi Rd
|
Northern
|
779
|
7.760-7.820
|
19-Jul-23
|
06-Sep-23
|
Mount Scanzi Rd
|
Northern
|
777
|
7.760-7.780
|
24-Jul-23
|
06-Sep-23
|
Mount Scanzi Rd
|
Northern
|
771
|
7.700-7.720
|
01-Aug-23
|
06-Sep-23
|
Mount Scanzi Rd
|
Northern
|
657
|
6.560-6.580
|
09-Aug-23
|
15-Aug-23
|
Mount Scanzi Rd
|
Northern
|
587
|
5.840-5.900
|
15-Aug-23
|
06-Sep-23
|
Mount Scanzi Rd
|
Northern
|
588
|
5.88
|
28-Aug-23
|
28-Aug-23
|
Suffolk Road
|
Basin
|
48
|
0.420-0.540
|
31-Jul-23
|
16-Aug-23
|
Wattamolla Rd
|
Northern
|
13
|
0.10-0.1600
|
29-Aug-23
|
08-Nov-23
|
Wattamolla Rd
|
Northern
|
356
|
3.56
|
22-Sep-23
|
09-Oct-23
|
Hughes Rd
|
Northern
|
199
|
1.980-2.000
|
06-Sep-23
|
26-Sep-23
|
Hughes Rd
|
Northern
|
197
|
1.960-1.980
|
12-Sep-23
|
05-Oct-23
|
Browns Mountain Rd
|
Northern
|
364
|
3.630-3.650
|
15-Aug-23
|
08-Sep-23
|
Wogamia Rd
|
Central
|
98
|
0.940-1.020
|
26-Sep-23
|
20-Oct-23
|
Abernathys Rd
|
Northern
|
191
|
1.900-1.920
|
29-Aug-23
|
19-Sep-23
|
Bamarang Rd
|
Central
|
325
|
3.240-3.360
|
12-Oct-23
|
23-Nov-23
|
Bamarang Rd
|
Central
|
319
|
3.180-3.200
|
01-Nov-23
|
23-Nov-23
|
Yalwal Rd
|
Central
|
957
|
9.56-9.60
|
07-Nov-23
|
20-Nov-23
|
Moderate Landslip Repair Package
Location
|
Rural address No. (approx)
|
Browns Mountain Rd |
296 |
Browns Mountain Rd |
282 |
Browns Mountain Rd |
286 |
Bunkers Hill Rd |
194 |
Emerys Rd |
19 |
Greville Av |
TBA |
Greville Av |
150 |
Hughes Rd |
222 |
Hughes Rd |
154 |
Kangaroo Valley Rd |
228 |
Kangaroo Valley Rd |
1162 |
Kangaroo Valley Rd |
116 |
Kangaroo Valley Rd |
1246 |
Kangaroo Valley Rd |
230 |
Kangaroo Valley Rd |
1168 |
Matron Porter Dr |
TBA |
Mt Scanzi Rd |
792 |
Mt Scanzi Rd |
800 |
Mt Scanzi Rd |
824 |
Mt Scanzi Rd |
782 |
Mt Scanzi Rd |
636 |
Mt Scanzi Rd |
692 |
Tourist Rd |
TBA |
Tourist Rd |
26 |
Upper Kangaroo River |
1260 |
Wattamolla Rd |
388 |
Wattamolla Rd |
366 |
Wattamolla Rd |
404 |
Wattamolla Rd |
396 |
Wattamolla Rd |
311 |
Wattamolla Rd |
402 |
Wattamolla Rd |
666 |
Completed & Upcoming Road Works (Stage 3)
The information below provides an overview of the roads impacted by the natural disasters and tender information for each district.
Request for Tender timelines are unfortunately delayed. Council is awaiting approval from TfNSW and NSW Reconstruction. Individual project pages will be updated as soon as confirmation is received.
To see more detailed information regarding the individual road works, use the links in All Works and subscribe to remain updated.
Northern District
Completed Pavement
Rehabilitation
|
Upcoming Pavement
Rehabilitation
|
- Elliotts Ln, Meroo Meadow (unsealed)
- Schofields Ln, Berry (unsealed)
- Irvines Rd, Berry Mountain (unsealed)
- Jacks Corner Rd, Kangaroo Valley (unsealed)
- Woodhill Mt Rd, Woodhill (sealed patch before slip)
- Budgong Rd, Budgong (unsealed)
|
Unsealed Roads:
Round 1:
Geotechnical investigations underway. Request for Tender to be issued March 2023
- Illaroo Rd, North Nowra
- Hockeys Ln, Cambewarra
- Jacks Corner Rd, Kangaroo Valley
- Coolangatta Rd, Coolangatta
Round 2 & 3:
Work being scoped. Request for Tender to be issued mid-March 2023.
- Kangaroo Valley Rd, Berry Mountain
- Hillandale Rd, Broughton Vale
- Agars Ln, Berry
- Main Rd, Cambewarra
- Gerroa Rd, Coolangatta
- Irvines Rd, Berry Mountain
|
Central District
Completed Pavement
Rehabilitation
|
Upcoming Pavement
Rehabilitation
|
Round 1:
- Cabbage Tree Lane, Nowra Hill
- Callala Beach Rd, Callala Beach
- Culburra Rd, Wollumboola
- Jindy Andy Lane, Pyree
- Worrigee Rd, Worrigee
Round 2:
- Greenwell Point Rd, Brundee
- South St & Comerong Island Rd, Terara
|
Round 3:
Geotechnical advice being sought. Round 3 Request for Tender to be called February 2023:
- Terara Road, Terara
- Commerong Island Road, Numbaa
- Millbank Road, Terara
- Burrier Road, Barringella
- Yalwal Road, West Nowra
- Culburra Rd, Wollumboola
|
Basin District
Completed Pavement
Rehabilitation
|
Upcoming Pavement
Rehabilitation
|
Round 1:
- The Wool Road, Basin View
- Naval College Road, Basin View
- Evelyn Road, Basin View
- Jervis Bay Road, Jervis Bay
- Roper Street, Vincentia
- Pine Forest Road, Tomerong
- Murray Street, Vincentia
- Woollamia Road, Falls Creek
|
Round 2:
Round 2 Contract awarded. Work commences Jan 2023.
- Cammaray Dr, St Georges Basin
- Tilbrook Av, St Georges Basin
- Albion St, Sanctuary Point
Round 3:
Finalising scope. Request for Tender to be issued Feb 2023.
- Braidwood Rd, Sassafras
- Jervis Bay Road, Falls Creek
- Turpentine Rd, Tomerong
- Dowling Street, Falls Creek
|
Southern District
Completed Pavement
Rehabilitation
|
Upcoming Pavement
Rehabilitation
|
|
Round 1:
Geotechnical advice is being engaged. Request for Tender to be issued in March 2023.
- Woodstock Rd, Woodstock
- Lake Conjola Entrance Rd, Yatte Yattah
- Sussex Inlet Rd, Tullarwalla
- Fisherman’s Paradise Rd /Alma Av, Fisherman’s Paradise
- Inyadda Dr, Manyana
- Bendalong Rd, Bendalong
|
All Works
Status |
Location |
District |
Last updated |
Road status |
Restrictions |
done
|
1 Albion Street, Sanctuary Point 2540
|
|
13 March 2023
|
Open
|
|
done
|
4 Cammaray Drive, St Georges Basin 2540
|
|
20 March 2023
|
Closed
|
|
done
|
Abernethys Road, Budgong 2577
|
Northern
|
16 March 2023
|
Open
|
3 tonne
|
done
|
Abernethys Road, Budgong 2577
|
Northern
|
02 March 2023
|
Open
|
Load limit
3 tonne
|
done
|
Agars Lane, Berry 2535
|
|
02 March 2023
|
Open
|
|
done
|
Bamarang Road, Bamarang 2540
|
Central
|
04 March 2023
|
Open
|
|
done
|
Barfield Rd, Cambewarra 2541
|
Northern
|
09 March 2023
|
Open
|
|
done
|
Beach street, Huskisson 2540
|
Basin
|
19 December 2022
|
Open
|
|
done
|
Bendalong road, Bendalong 2539
|
|
16 March 2023
|
Open
|
Reduced speed
|
done
|
Braidwood Road, Tianjara 2622
|
Basin
|
21 February 2023
|
Open
|
One way
|
done
|
Braidwood Road, Sassafras 2622
|
Basin
|
14 March 2023
|
Open
|
Reduced speed
Road damage
|
done
|
Browns Mountain Road, Browns Mountain 2540
|
Northern
|
16 March 2023
|
Open
|
|
done
|
Bryces Rd, Far Meadow 2535
|
Northern
|
09 March 2023
|
Open
|
No restrictions
|
done
|
Bunkers Hill Road, Barrengarry 2577
|
|
16 March 2023
|
Closed
|
Load limit
5 tonne
Residents only
|
done
|
Burrier Road, Burrier 2540
|
Central
|
19 January 2023
|
Open
|
Reduced speed
|
done
|
Burrier Road, Burrier 2540
|
Central
|
04 March 2023
|
Open
|
Reduced speed
Traffic lights
|
done
|
Cabbage Tree Lane, Nowra Hill 2540
|
|
18 November 2022
|
Open
|
|
done
|
Callala Beach Road, Callala Beach 2540
|
|
18 November 2022
|
Open
|
|
done
|
Comerong Island, Terara 2540
|
Central
|
02 March 2023
|
Open
|
No restrictions
|
done
|
Coolangatta Road, Coolangatta 2535
|
Northern
|
23 March 2023
|
Open
|
Reduced speed
|
done
|
Croziers Road, Jaspers Brush 2535
|
Northern
|
23 March 2023
|
Open
|
12 tonne
|
done
|
Culburra Rd, Wollumboola 2540
|
|
19 January 2023
|
Open
|
|
done
|
Dowling Street, Falls Creek 2540
|
|
24 February 2023
|
Open
|
|
done
|
Duffys Lane, Budgong 2577
|
Northern
|
13 February 2023
|
Open
|
|
done
|
Evelyn Rd, Tomerong 2540
|
|
18 November 2022
|
Open
|
|
done
|
Fishermans Paradise Road, Fishermans Paradise 2539
|
Southern
|
09 February 2023
|
Open
|
|
done
|
Foremans Road, Woodhill 2535
|
|
16 March 2023
|
Closed
|
Load limit
5 tonne
Residents only
|
done
|
Gerroa Road, Coolangatta 2540
|
Northern
|
02 March 2023
|
Open
|
Road damage
|
done
|
Greenwell Point Road, Worrigee 2540
|
Central
|
17 March 2023
|
Open
|
|
done
|
Hillandale Road, Broughton Vale 2535
|
Northern
|
03 March 2023
|
Open
|
|
done
|
Hockeys Lane, Tapitallee 2540
|
Northern
|
23 March 2023
|
Open
|
|
done
|
Hughes Road, Illaroo 2540
|
Northern
|
16 March 2023
|
Open
|
|
done
|
Illaroo Road, North Nowra 2540
|
|
23 March 2023
|
Open
|
Reduced speed
|
done
|
Irvines Rd, Berry Mountain 2540
|
Northern
|
02 March 2023
|
Open
|
|
done
|
Island Point Road, St Georges Basin 2540
|
Basin
|
02 March 2023
|
Closed
|
|
done
|
Jacks Corner, Kangaroo Valley 2577
|
Northern
|
23 March 2023
|
Open
|
|
done
|
Jervis Bay Road, Falls Creek 2540
|
|
07 February 2023
|
Open
|
|
done
|
Jindy Andy Lane, Pyree 2540
|
|
18 November 2022
|
Open
|
|
done
|
Kangaroo Valley, Berry Mountain 2535
|
Northern
|
02 March 2023
|
Open
|
|
done
|
Kangaroo Valley Road, Kangaroo Valley 2577
|
Northern
|
16 March 2023
|
Open
|
Load limit
12 tonne
Reduced speed
|
done
|
Lake Conjola Entrance Road, Yatte Yattah 2577
|
Southern
|
09 February 2023
|
Open
|
|
done
|
Main road, Cambewarra Village 2540
|
Northern
|
02 March 2023
|
Open
|
|
done
|
Martinvale Road, Jaspers Brush 2535
|
Northern
|
23 March 2023
|
Open
|
|
done
|
McMahons Rd, North Nowra 2541
|
Northern
|
09 March 2023
|
Open
|
No restrictions
|
done
|
Millbank Road, Terara 2540
|
Central
|
16 February 2023
|
Open
|
|
done
|
Mount Agony Road, Durras North 2539
|
Southern
|
13 March 2023
|
Open
|
|
done
|
Mt Scanzi Road, Kangaroo Valley 2577
|
Northern
|
16 March 2023
|
Open
|
One lane
|
done
|
Murray St - Vincentia, Vincentia 2540
|
|
18 November 2022
|
Open
|
|
done
|
Naval College Road, Worrowing Heights 2540
|
|
10 March 2023
|
Open
|
|
done
|
Old Burrier Road, Burrier 2540
|
Central
|
17 March 2023
|
Open
|
|
done
|
Penguins head road, Culburra Beach 2540
|
Central
|
16 February 2023
|
Open
|
|
done
|
Pine Forest Road, Tomerong 2540
|
|
01 February 2023
|
Open
|
|
done
|
Porters Creek Road, Pointer Mountain 2539
|
Southern
|
22 March 2023
|
Open
|
|
done
|
Roper St - Vincentia, Vincentia 2540
|
|
18 November 2022
|
Open
|
|
done
|
Roskell road, Callala Beach 2540
|
Central
|
17 March 2023
|
Open
|
|
done
|
Schofields Lane, Berry 2540
|
Northern
|
21 December 2022
|
Open
|
|
done
|
Scott St, Shoalhaven Heads 2540
|
Northern
|
21 March 2023
|
Closed
|
Road damage
|
done
|
Suffolk Road, Tomerong 2540
|
Basin
|
04 March 2023
|
Open
|
One lane
Residents only
|
done
|
Sussex Inlet Road, Tullarwalla 2577
|
Southern
|
09 February 2023
|
Open
|
|
done
|
Terara Road, Terara 2540
|
Central
|
17 March 2023
|
Open
|
|
done
|
The Wool Road, Basin View 2540
|
|
15 March 2023
|
Open
|
No restrictions
|
done
|
Tilbrook Avenue, St Georges Basin 2540
|
|
20 March 2023
|
Open
|
|
done
|
Tourist Road, Beaumont 2577
|
|
22 November 2022
|
Open
|
|
done
|
Turpentine Road, Tomerong 2540
|
Basin
|
24 February 2023
|
Open
|
Reduced speed
Road damage
|
done
|
Upper Kangaroo River Road, Upper Kangaroo River 2577
|
|
16 March 2023
|
Closed
|
9 tonne
Residents only
|
done
|
Wattamolla Road, Wattamolla 2535
|
Northern
|
07 February 2023
|
Open
|
Load limit
9 tonne
|
done
|
Wattamolla Road, Woodhill 2535
|
Northern
|
16 March 2023
|
Open
|
Load limit
9 tonne
|
done
|
Wogamia Road, Longreach 2540
|
Central
|
04 March 2023
|
Open
|
Road damage
|
done
|
Woodburn Road, 2538
|
Southern
|
13 March 2023
|
Open
|
Reduced speed
|
done
|
Woodhill Mountain Road, Woodhill 2535
|
Northern
|
16 March 2023
|
Open
|
One lane
Reduced speed
Traffic lights
|
done
|
Woodstock road, Morton 2538
|
Southern
|
13 March 2023
|
Open
|
Reduced speed
|
done
|
Woollamia Rd, Falls Creek 2540
|
|
18 November 2022
|
Open
|
|
done
|
Yalwal Road, Yalwal 2540
|
Central
|
04 March 2023
|
Open
|
Road damage
|
done
|
Yalwal Road, Mundamia 2540
|
Central
|
17 March 2023
|
Open
|
Gravel
|
Interim Slip Repairs – Completed (Stage 2 )
The following land slip, interim works have completed under Stage 2 (immediate reconstruction works), to allow restricted traffic access under strict load limits:
- Wattamolla Rd – two locations
- Upper Kangaroo River Rd – two locations
- Foremans Rd
- Woodhill Mountain Rd
- Suffolk Rd
Current Road Load Limits
The following roads have strict load limits imposed for public safety:
Address
|
Dry Weather Load Limit
|
At 136 Bunkers Hill Rd, Kangaroo Valley
|
5 tonne– resident access only, closed to other traffic
24/7 load & traffic restriction enforcement in place
|
At 368B Bunkers Hill Rd, Kangaroo Valley
|
Closed to all traffic. New cracks in roadway detected
|
At 40 Foremans Rd, Kangaroo Valley
|
5 tonne – resident access only, closed to other traffic
|
Wattamolla Rd, Woodhill Mountain
|
9 tonne, entire length
24/7 load & traffic restriction enforcement in place
|
At 685 Upper Kangaroo River Road, Upper Kangaroo River
|
9 tonne – resident access only, closed to other traffic
24/7 load & traffic restriction enforcement in place
|
Kangaroo Valley Road, Kangaroo Valley |
12 tonne |
Abernethys Rd, Budgong |
3 tonne |
Crozier Rd, Jaspers Brush |
12 tonne |
The imposed road load limits at various slip sites have been confirmed by Council’s geotechnical consultants by applying slope stability analysis. This considers vehicle loads, geology, soil conditions and road embankment slopes to derive a factor of safety against further embankment collapse.
Refer related documents for more information.
Vehicle Weight Limit Exemption Application
Council road management staff will consider requests for an exemption to a load limit at a landslip site, and this can be done by downloading and completing the SCC Application Form – Load Limit Exemption.
Any consideration of a temporary load limit exemption would be on a risk assessment of slope stability undertaken by Council’s geotechnical consultant.
Allow at least 10 business days to have this application considered.
Road Closures - Trigger Action Response Plan (TARP)
This TARP assists us to manage existing and historical land slip sites based on predicted rainfall events.
Roads currently affected with load limits imposed due to landslips can deteriorate and slip further due to further heavy rainfall. Council has trigger points when deciding to close a road to all traffic for safety reasons:
Predicted rainfall in
a 24-hour period
|
Council Action
|
Less than 50mm
|
- Manage road as if under “Dry Conditions” with daily inspections.
- Should new tension cracks or edge slumps appear, or increase, the road will be closed at the landslip site and reopened pending engineering advice.
|
Between 50mm and 100mm |
- Continue to manage road as if under “Dry Conditions” with increased frequency of inspections.
- If new tension cracks or edge slumps appear, or increase, the road will be closed at the landslip site and reopened pending engineering advice.
|
Above 100mm |
- CLOSE ROAD (just before rain commences)
- Inspection to occur only when rain has stopped.
- The road is only re-opened after surface water has dissipated and no further rain is imminent.
- If new tension cracks or edge slumps appear, or increase, the road will remain closed and only be reopened pending engineering advice.
|
The nature of the landslip hazard is such that in most cases it is not possible to give notice of a road closure before a road closure is implemented. Council understands the impact that a road closure can have on residents and the Community and only implement such measures in the face of imminent hazardous conditions.
Storm and Flood Customer Care Service

If you have been affected by the March or July 2022 severe storms and floods, there are a range of assistance measures that may be available to support you.
